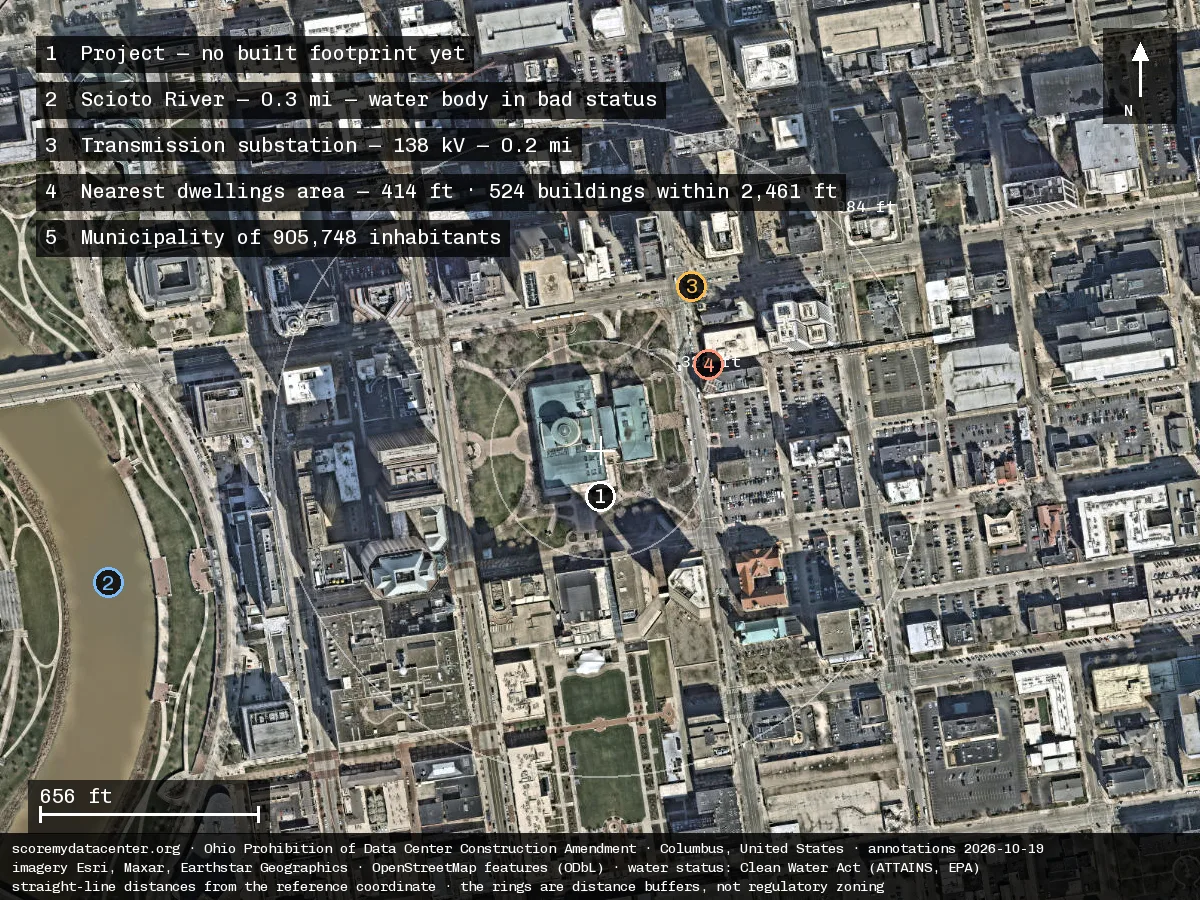

Annotated aerial view of Ohio Prohibition of Data Center Construction Amendment in Columbus: footprint, watercourse, substation and nearest dwellings, with measured distances.

Probable grade, wide window

This project is not in service: we publish a probable grade C and the range it can still move within B–E. The probable grade is computed on the sourced indicators alone; the range says what the missing ones could still change. It is wider than usual here — that width measures what is missing, not doubt about the calculation. It narrows as the file fills in.

Pillar sub-scores

A pillar mixes what is endured and what is chosen; a grade is not the average of the pillars.
●●●○ = documentation available
Energy
Energy
●○○○

Missing: Grid connection capacity / proximity, PUE (announced energy efficiency), Heat-network connectability, Waste-heat recovery — commitment.

Water
Water
●●●○

Missing: Basin withdrawal pressure, Cooling technology + announced water volume.

Land & biodiversity
Land & biodiversity
●●●○

Missing: Ecological corridors (TVB), Site ground footprint, Avoid-reduce-offset (ERC) measures, Designated for urbanisation in a supra-municipal plan, Planning-document compatibility procedure under way.

Local impact
Local impact–
Transparency & governance
Transparency & governance–

“Rated C on site, but D on “Water”.”

This site is among the 92% of the fleet built on already-artificialized soil. Fleet figures →

This site is in United States — the country's site index: C (55.8). See the country index →

Tracked indicators

IndicatorValueReadingStateSource
Energy
Local grid carbon intensity How much CO₂ is emitted to produce the electricity the site will consume, based on the regional grid. The lower the value, the better. 413.4 gCO2e/kWh Measured EPA eGRID2023 (rev2) — subregion RFCW annual CO2 output emission rate 911.424 lb/MWh = 413.4 gCO2/kWh (×0.45359237; subregion polygon at point, fixed vintage) — accessed 2026-10-16
Grid connection capacity / proximity How easily the site can be connected to the power grid: available capacity and distance to the nearest substation. — — Not looked for yet We have not looked for this yet. It is dropped from the calculation and does not penalise the site. —
Grid congestion / connection queue How congested the local grid is: the more saturated, the more the connection competes with other users. moderate local grid congestion Measured LBNL Queued Up thru2025 (Queued Up 2026 edition) (LBNL + GridTracker, CC BY 4.0) — région PJM : abandon historique 81.4%, attente médiane 3.2 ans, 130.6 GW actifs ; classe «moderate» = table signée 2026-10-16 (correspondance région→e3, précédent NL) — accessed 2026-10-16
PUE (announced energy efficiency) The announced energy efficiency: total electricity used versus what actually powers computing. Closer to 1 is better. The lower the value, the better. — — Not looked for yet We have not looked for this yet. It is dropped from the calculation and does not penalise the site. —
Heat-network connectability Whether the site can valorise its waste heat via a district-heating network: distance to the nearest network and presence of a connection obligation (priority development perimeter). Not disclosed — Absent from the file We read the public file and the information is not in it. It counts as a zero in the grade. —
Waste-heat recovery — commitment Operator commitment level to valorise the site's waste heat (delivered / signed contract / study / intention / none). — — Not looked for yet We have not looked for this yet. It is dropped from the calculation and does not penalise the site. —
Water
Local water stress Water tension in the area: in an already water-scarce region, withdrawals weigh more heavily. moderate water stress Measured WRI Aqueduct 4.0 baseline water stress at point — 'Medium - High (20-40%)' (bws_cat 2/4) — accessed 2026-10-16
Water body status The ecological health of the affected river or aquifer, per the EU classification (from 'high' to 'bad'). water body in bad status Measured EPA ATTAINS — Scioto River Mainstem (L. Scioto R. to Olentangy R.); excluding O'Shaughnessy and Griggs reservoirs : Not Supporting (IR 5 — inscrite 303(d), cycle 2024) ; IR→enum = table signée 2026-10-16 (même enum que WISE/GB, comparabilité par construction) — accessed 2026-10-16
Basin withdrawal pressure How intensively water is already withdrawn from the basin: a heavily-tapped basin ill affords a new user. — — Not looked for yet We have not looked for this yet. It is dropped from the calculation and does not penalise the site. —
Cooling technology + announced water volume The cooling technology chosen and the water volume it will consume, as announced by the operator. — — Not looked for yet We have not looked for this yet. It is dropped from the calculation and does not penalise the site. —
Land & biodiversity
Overlap / distance to protected areas How close the project is to protected natural areas (Natura 2000, nature reserves…). protected natural area 1–5 km away Measured USGS PAD-US, GAP status 1/2 (areas managed for biodiversity — the Natura/CDDA analog; GAP 3/4 local parks and easements excluded) — overlap by distance ring (Alum Creek/Hanford Parkland, Harmon-Emig Parkland, Perhar Parkland) — accessed 2026-10-16
Soil status (artificialized / natural / agricultural) What the land was before: already built (brownfield), natural, or farmland — sealing farmland or nature weighs most. previously developed land Measured NLCD 2021 land cover (USGS/MRLC, 30 m) — class 24 at point — accessed 2026-10-16
Ecological corridors (TVB) Whether the project severs a wildlife corridor (green-and-blue network). Not disclosed — Absent from the file We read the public file and the information is not in it. It counts as a zero in the grade. —
Site ground footprint The SITE's ground footprint in hectares — the land the project takes up (buildings, roads, parking, substation, retention basins), not the building print alone: the larger, the greater the land impact. The lower the value, the better. — — Not looked for yet We have not looked for this yet. It is dropped from the calculation and does not penalise the site. —
Avoid-reduce-offset (ERC) measures Measures to avoid, reduce or offset harm to soil artificialisation and biodiversity. (Heat recovery moved to E6/E7, Energy pillar.) — — Not looked for yet We have not looked for this yet. It is dropped from the calculation and does not penalise the site. —
Designated for urbanisation in a supra-municipal plan not scored · contextual fact Is the site designated for urbanisation in a planning document above the municipality? A contextual fact, published as such: it neither improves nor worsens the grade. — — Not looked for yet We have not looked for this yet. It is dropped from the calculation and does not penalise the site. —
Planning-document compatibility procedure under way not scored · contextual fact Is a procedure under way to make the planning document compatible with the project? A contextual fact: we follow the instrument, not the intention — the land status only changes the day the procedure completes. — — Not looked for yet We have not looked for this yet. It is dropped from the calculation and does not penalise the site. —
Local impact
Municipality socio-economic profile The host town's social profile. A safeguard: a project must never improve its grade by locating in a vulnerable town. — — Not looked for yet We have not looked for this yet. It is dropped from the calculation and does not penalise the site. —
Absorption capacity (project size vs municipality) The project's size relative to the town: a very large project in a small town disrupts more. The lower the value, the better. Not disclosed — Absent from the file We read the public file and the information is not in it. It counts as a zero in the grade. —
Technological hazard / nearby Seveso sites The presence of hazardous industrial sites (Seveso) nearby, adding risk to the surroundings. — — Not looked for yet We have not looked for this yet. It is dropped from the calculation and does not penalise the site. —
Announced jobs The number of permanent jobs announced, relative to project size. More is better. The higher the value, the better. — — Not looked for yet We have not looked for this yet. It is dropped from the calculation and does not penalise the site. —
Announced tax revenue The tax revenue the project would bring to the town, as announced. — — Not looked for yet We have not looked for this yet. It is dropped from the calculation and does not penalise the site. —
Observed level of opposition The scale of observed opposition: appeals, petitions, mobilizations reported by the press. Not disclosed — Absent from the file We read the public file and the information is not in it. It counts as a zero in the grade. —
Elected officials' position (voted facts only) Elected officials' position as expressed by official votes only (council decisions), with no personal judgment. Not disclosed — Absent from the file We read the public file and the information is not in it. It counts as a zero in the grade. —
Transparency & governance
Consultation / consent / governance (procedural proxies) The quality of the democratic process: public inquiry held, environmental authority opinion, appeals, CNDP referral. — — Not looked for yet We have not looked for this yet. It is dropped from the calculation and does not penalise the site. —
Documentation transparency / file availability How genuinely accessible the project's file is to the public: published studies, figures and commitments. — — Not looked for yet We have not looked for this yet. It is dropped from the calculation and does not penalise the site. —

Operator response

The operator can send us a response about this datasheet. When a response is received and publishable, it appears here, clearly attributed and dated.

A factual error? Use “Report an error”, attaching a source or supporting document.

State of the available data

26 indicators tracked · 6 measured · 0 announced (unverified) · 5 absent from the file · 15 not looked for yet.

Grade history

Methodology 0.3.0 scoremydatacenter.org
